Virtual Public Meeting for FM 2931 Improvements

Farm to Market Road (FM) 2931

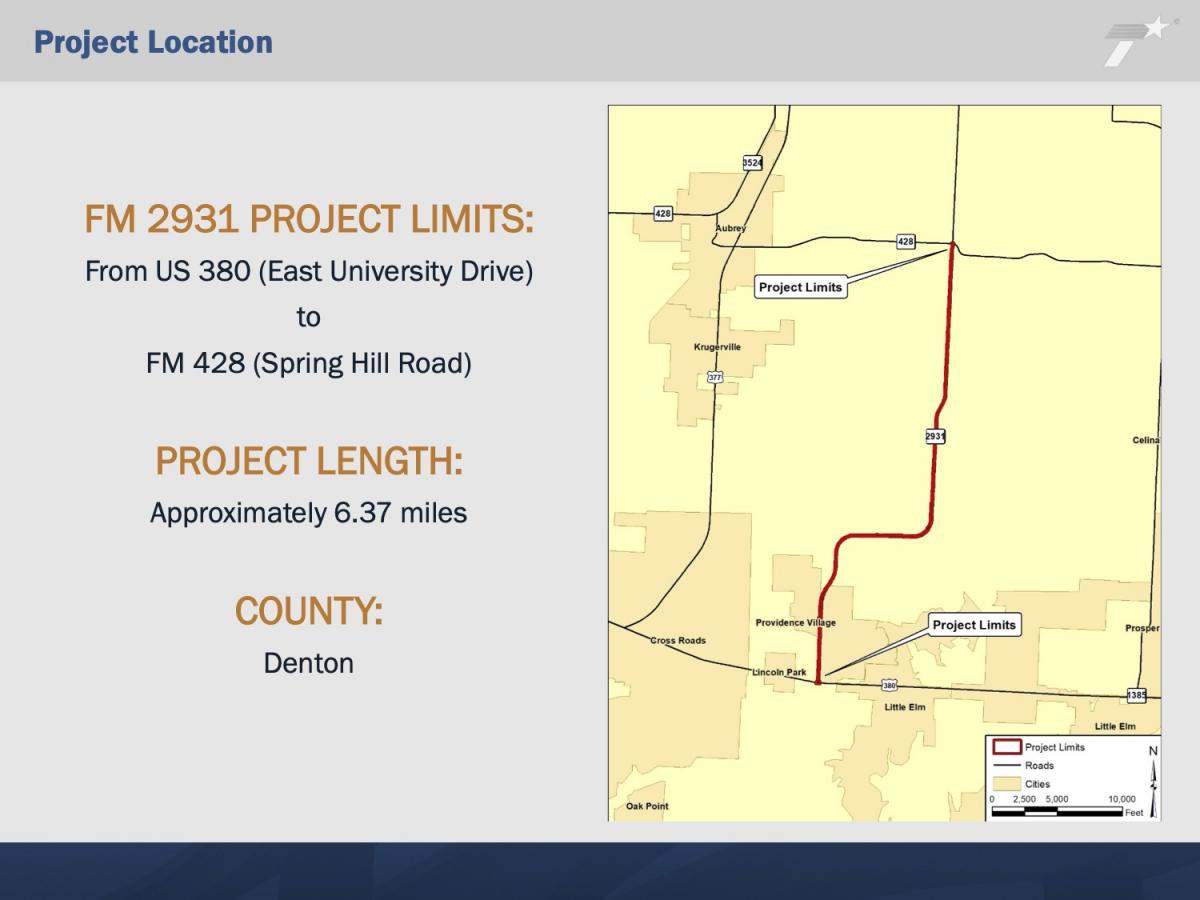

From United States Highway (US) 380 (East University Drive) to FM 428 (Spring Hill Road)
Denton County, Texas
CSJ: 2979-01-011

July 7, 2020

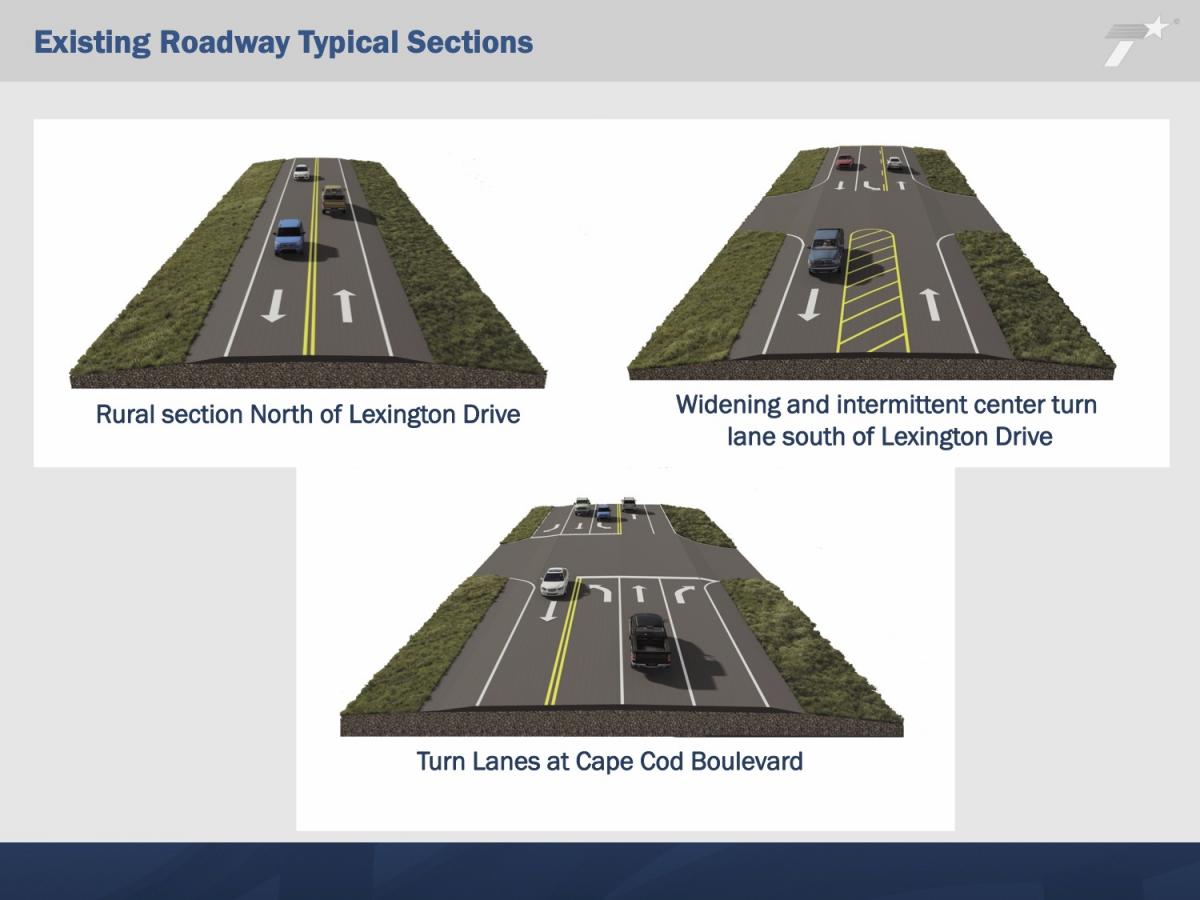

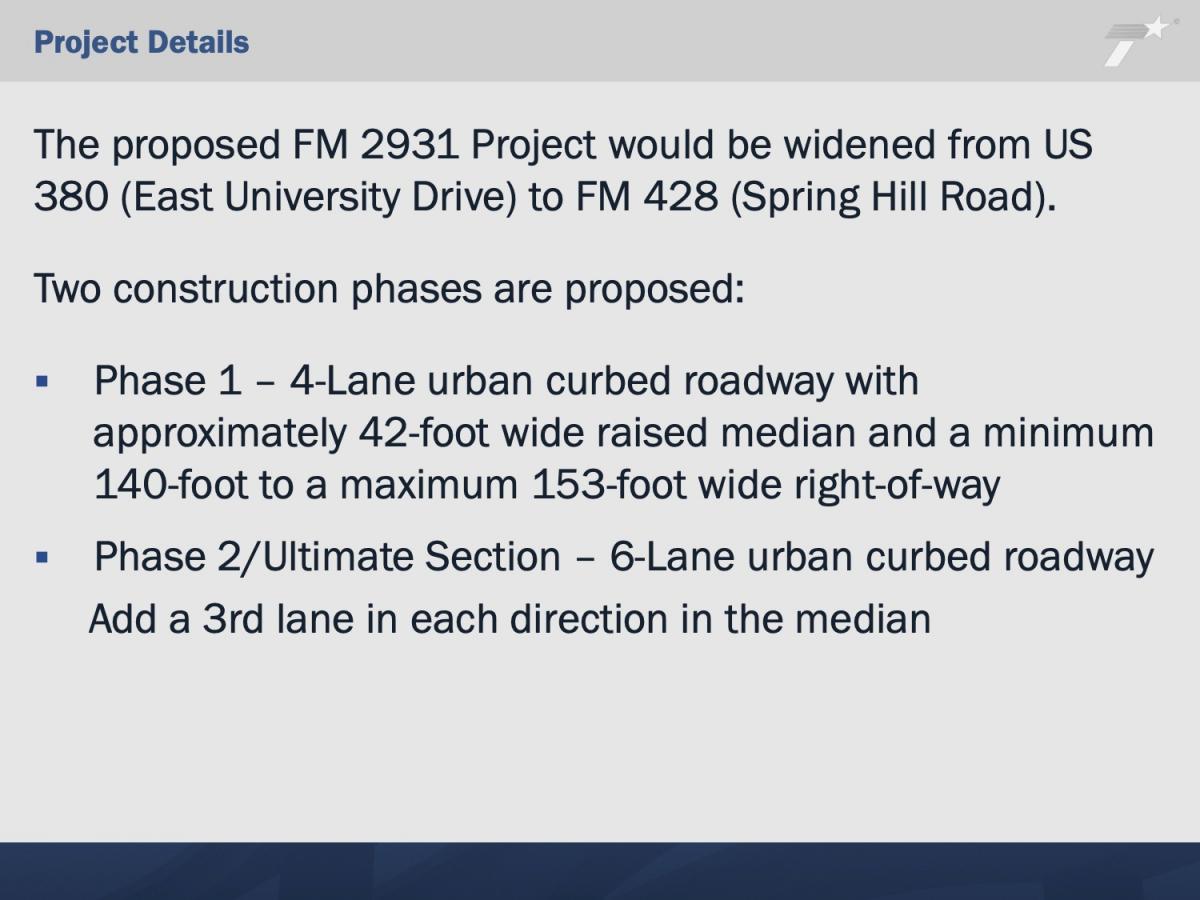

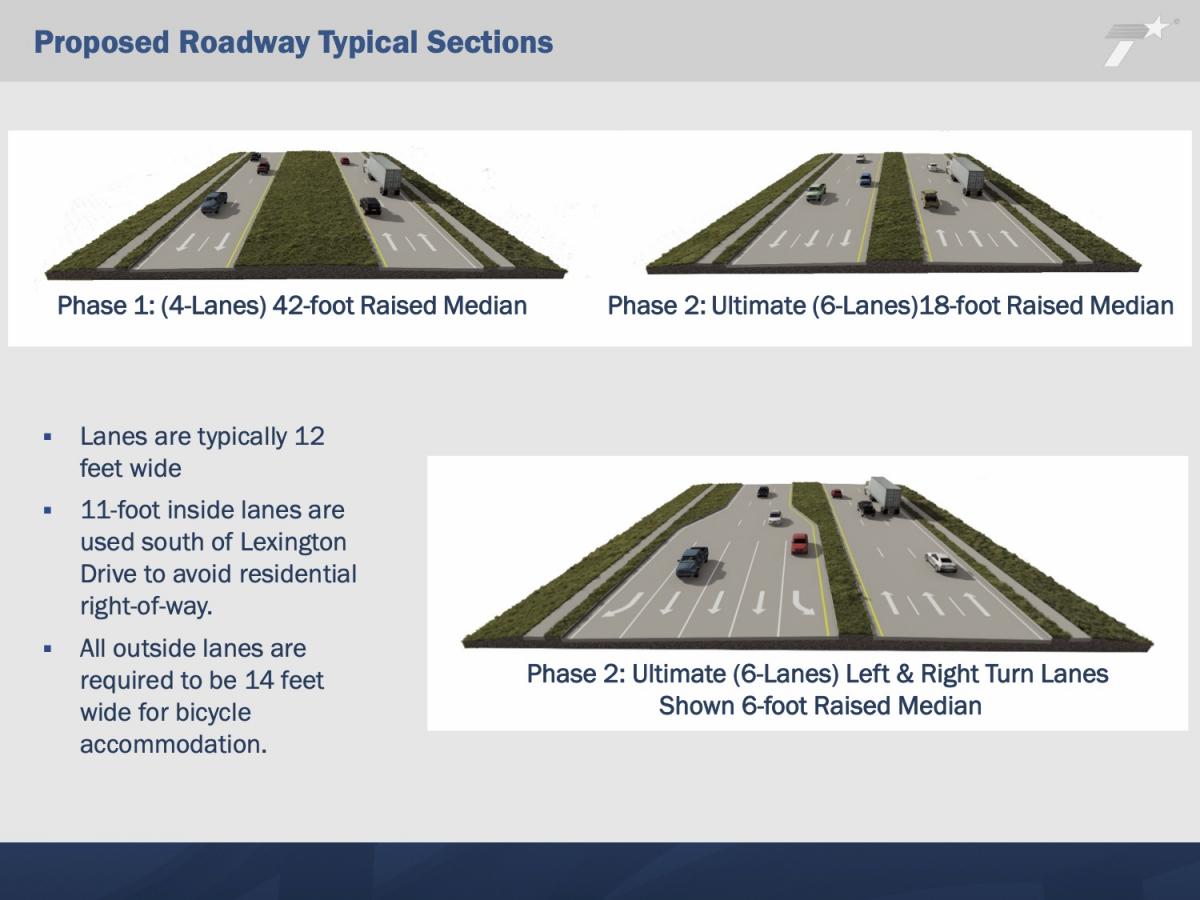

The FM 2931 reconstruction project includes widening approximately 6.37 miles of FM 2931 from US 380 (East University Drive) to FM 428 (Spring Hill Road). The existing FM 2931 is a rural 2-lane roadway. The existing right-of-way width is approximately 100 feet wide.  The proposed FM 2931 would be reconstructed as a 4-lane urban roadway (ultimate 6-lane) section with turn lanes. Sidewalks would be added on both sides of the roadway. The proposed right-of way would be approximately 140 to 153 feet wide. Approximately 46 acres of new ROW would be required to accommodate the proposed improvements. No relocations or displacements are anticipated.

This virtual meeting begins on July 7, 2020 and will remain available online through the comment period deadline of July 22, 2020. During this time, please view the video presentation and exhibits provided on this site to learn about the project, and provide your comments.

PRESENTATION

Click this link to view the narrated video presentation: https://youtu.be/mIWLPSsYR-w

EXHIBITS

You may click on any of the project exhibits below to view them at full size.

Click the links below to view the 30% Schematic for the FM 2931 project. The Roll Index provides an overview to help locate your property on the map rolls.

Schematic Roll Index
Schematic Roll 1 – FM 428/Spring Hill Road to Knuckles Road
Schematic Roll 2 – Knuckles Road to Liberty Road
Schematic Roll 3 – Liberty Road to US 380/East University Drive
Schematic Roll 4 – Typical Sections

RIGHT-OF-WAY (ROW) INFORMATION

The proposed project would require approximately 46 acres of new ROW. Although additional ROW would be required, no displacements are anticipated.

Information about the process for state purchase of ROW and relocation assistance may be found in the following pamphlets:

Relocation Assistance: ENGLISH or SPANISH
State Purchase of ROW: ENGLISH or SPANISH

HOW TO PROVIDE COMMENTS

The deadline for providing comments is July 22, 2020.

Comments may be provided online, or by mail, email, or voicemail, as explained below.

Comment Online: Comments may be completed and submitted online by clicking this link: https://www.surveymonkey.com/r/9C6JPVG

Comment via Email or Mail: The PDF Comment Form may be completed on the computer or printed and handwritten, and can be submitted by email or mail. Click the links below for the PDF Comment Form.

PDF Comment Form: ENGLISH or SPANISH

Email comments to [email protected]

Mail comments to:
TxDOT Dallas District Office
Attention Edra Brashear, P.E.
4777 East US Highway 80
Mesquite, TX 75150-6643

Verbal Comments: Call (940) 220-9478 and leave your comment on the voicemail. For the official documentation, please clearly state your name and address before your verbal comment. You will be able to record a 3-minute long verbal comment. Your comment will be transcribed and included in the meeting documentation.

QUESTIONS?

Contact the TxDOT project manager, Edra Brashear, P.E., to ask questions about the project at [email protected] or (214) 320-6651.



Public Meeting Documentation
